April 27:The Sinking of the SS Sultana161yr ago

How the US Military Built a 1,200-Foot Bridge Across the Euphrates in 8 Hours

James Holloway · · 11 min read
Save
Share:

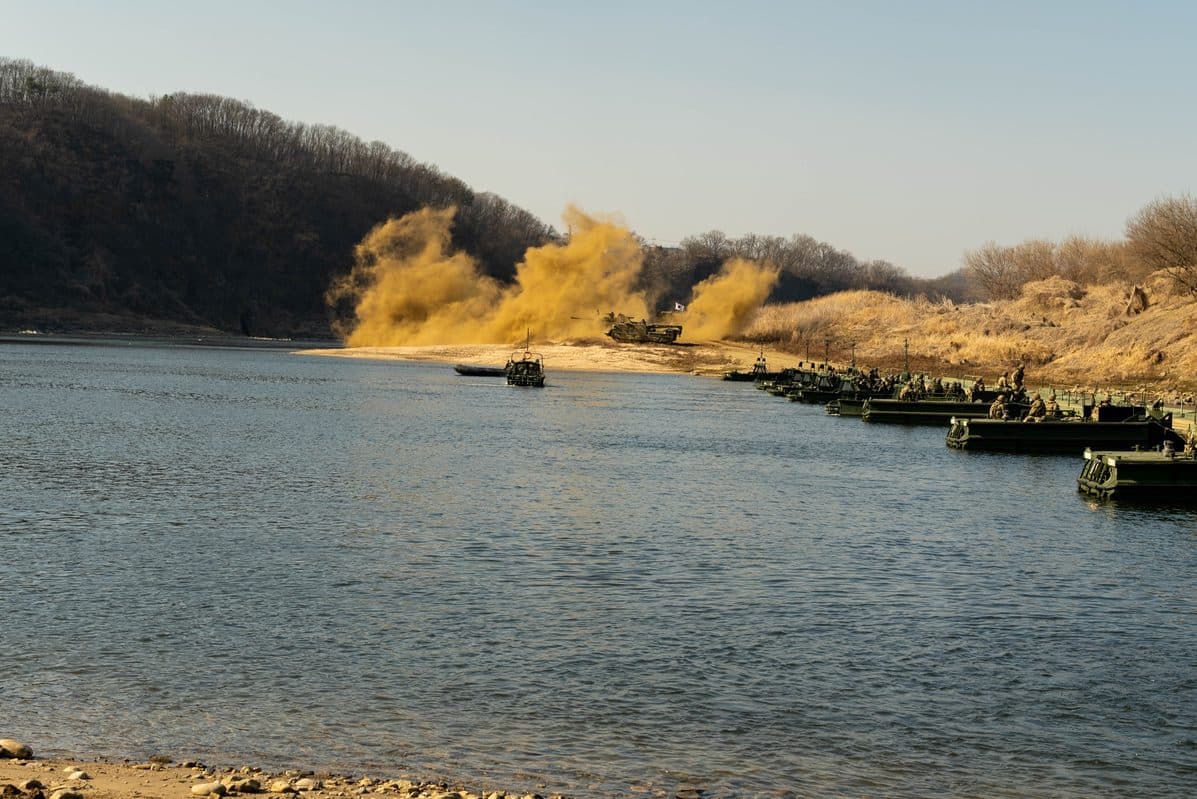

M1 Abrams tank positioned on an Improved Ribbon Bridge during a wet gap crossing test, with the floating bridge structure visible beneath the tank's tracks
James Holloway
James Holloway

Military Logistics & Sustainment Analyst

James Holloway writes about military readiness, logistics, and the practical limits of modern forces. His work focuses on how training, sustainment, and organizational decisions shape what militaries can actually do -- not just what they are designed to do on paper.

On the night of April 3, 2003, soldiers from the 299th Multi-Role Bridge Company began dropping aluminum pontoon bays into the Euphrates River south of Baghdad. The highway bridge at Objective Peach, near Al Musayyib, had been partially destroyed, not enough to block it entirely, but enough that the 3rd Infantry Division's commanders didn't trust it to carry the weight of dozens of 70-ton M1 Abrams tanks rolling across in rapid succession during the final push toward the Iraqi capital.

Working through the night to minimize exposure to enemy observation, the engineers assembled a 185-meter floating bridge from modular aluminum sections that unfolded from the backs of trucks directly into the river. By dawn, M1 Abrams tanks, M2 Bradley fighting vehicles, and heavy logistics trucks were rolling across the Euphrates on a bridge that hadn't existed twelve hours earlier. The 299th's bridge at Objective Peach was the first American assault river crossing since the Vietnam War, and it helped make possible the fastest armored advance in military history.

This is the story of how the U.S. military crosses rivers, and why the unglamorous engineering behind floating bridges has shaped the outcome of wars for centuries.

The Improved Ribbon Bridge: Aluminum Origami on an Industrial Scale

The Improved Ribbon Bridge (IRB) is the U.S. military's primary wet gap crossing system for heavy forces. Manufactured by General Dynamics European Land Systems, the IRB is a modular floating bridge composed of two types of sections: interior bays and ramp bays. Understanding how these components work reveals an elegant engineering solution to one of warfare's oldest logistical problems.

Each interior bay is a self-contained pontoon made of aluminum that measures 6.92 meters long, 8.63 meters wide when unfolded, and 1.30 meters high. It weighs approximately 6,350 kilograms. The key word is "unfolded", in transport configuration, each bay is folded into a compact package that fits on a standard military truck. The bay is essentially a three-panel aluminum structure that hinges along its length.

Improved Ribbon Bridge sections connected and floating on a river, forming a continuous roadway across the water with vehicles visible on the far bank
An Improved Ribbon Bridge assembled across a river during a training exercise. Each interior bay unfolds automatically when released into the water, using buoyant forces to actuate a cable and lever system that locks the roadway into position.

Here's where the engineering gets clever. When the truck backs up to the riverbank and releases the bay into the water, the bay unfolds automatically. Buoyant forces acting on the submerged portions of the bay actuate a cable and lever system that drives the panels outward until they lock into a flat roadway configuration. No hydraulics. No electric motors. Just physics, the water itself provides the energy to transform a compact transported package into a wide, stable bridge section. An experienced crew can launch a single bay in under two minutes.

Ramp bays are similar in construction but include a hinged ramp section that reaches up to 2 meters above the waterline, allowing vehicles to drive from the riverbank onto the bridge surface. Two ramp bays, one on each bank, bookend the bridge, with as many interior bays as needed to span the gap between them.

A 100-meter bridge requires 13 interior bays and 2 ramp bays. A well-trained bridge company can assemble it in approximately 30 minutes. The bridge can also be configured as a multi-bay raft for ferry operations when a full bridge isn't feasible or necessary, useful when crossing extremely wide rivers or when the tactical situation demands a faster but lower-capacity solution.

The Load Rating That Matters: MLC 96

The IRB is rated for Military Load Classification (MLC) 80 for tracked vehicles and MLC 96 for wheeled vehicles. In practical terms, this means the bridge can support an M1 Abrams tank at approximately 70 tons, the heaviest vehicle in the U.S. Army's inventory. The MLC 96 wheeled rating accommodates Heavy Equipment Transporters (HETs) carrying additional tanks on their flatbed trailers.

This load capacity is critical because it determines whether an armored division can cross as a fighting force or whether it must leave its heaviest vehicles behind. A bridge that can handle everything except the main battle tank is operationally useless for a heavy maneuver brigade. The IRB's ability to carry an Abrams at full combat weight, with fuel, ammunition, and reactive armor, means that a river crossing doesn't break the formation's combat power.

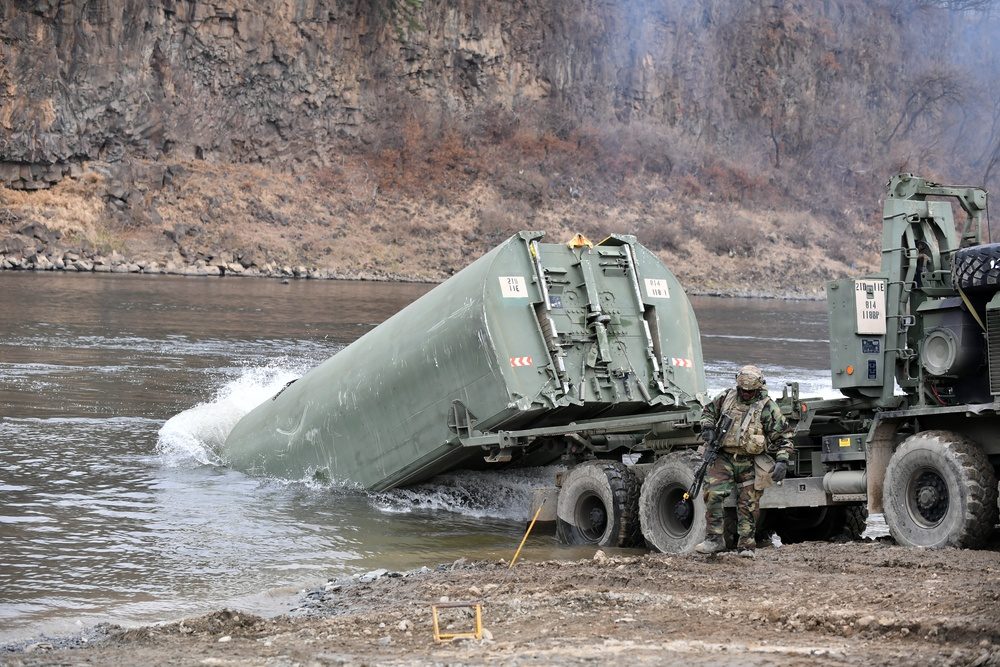

U.S. Army soldiers constructing a pontoon bridge section by section, with bridge boats maneuvering bay sections into position on the water
Soldiers assemble a pontoon bridge bay by bay during a training exercise. Each section must be precisely aligned and connected to the adjacent bays before the bridge can accept vehicle traffic.

The engineering challenge of floating a 70-ton tank on aluminum pontoons is substantial. The bridge bays must displace enough water to support the concentrated load of tank tracks, which apply far more pressure per unit area than wheeled vehicles. The connections between bays must handle enormous shear forces as the tank's weight transfers from one bay to the next. And the entire structure must remain stable against river current, wind, and the dynamic loading of vehicles accelerating and braking on the bridge surface.

Testing conducted by the U.S. Army Engineer Research and Development Center (ERDC) has pushed the IRB to its limits, including driving modified M1 Abrams tanks at various speeds across instrumented bridge sections to measure structural response. The data from these tests feeds directly into updated load tables that bridge company commanders use to determine how fast vehicles can cross and what spacing is required between heavy loads.

Objective Peach and the Race to Baghdad

The Euphrates crossing at Objective Peach in April 2003 illustrated every challenge that combat engineers face during a wet gap operation.

The 3rd Infantry Division had been advancing north at extraordinary speed, covering hundreds of miles in days during what would become the fastest armored advance in history. When lead elements reached the Euphrates, they found bridges that were damaged but not destroyed. The Iraqi military had partially demolished several crossings but hadn't completed the demolitions, possibly due to the speed of the American advance.

Division commanders faced a decision: trust the damaged highway bridge with the full weight of an armored brigade, or bring up the engineers to build a parallel crossing. They chose both, engineers would reinforce the existing bridge while simultaneously building a floating bridge alongside it.

The 299th Multi-Role Bridge Company, a U.S. Army Reserve unit, was tasked with the IRB crossing. They worked through the night of April 3, building the bridge under blackout conditions to minimize their exposure to enemy observation and indirect fire. The Euphrates at this point was approximately 150 meters wide, requiring a significant number of bays and a bridge construction time measured in hours rather than the 30 minutes achievable on a calm training site.

Staff Sergeant Cary Campbell arrived at the Euphrates on April 2 with a 12-man squad that would man and maintain the bridge for the next two weeks. The floating bridge was constructed primarily at night, and once operational, it carried a continuous flow of armored vehicles across the river as the 3rd Infantry Division consolidated its forces for the final push into Baghdad. The bridge remained in operation until April 18, handling thousands of vehicle crossings.

The AVLB: When You Need a Bridge in 90 Seconds

The Improved Ribbon Bridge excels at spanning wide water obstacles, but it requires time, personnel, and protected access to the riverbank. For shorter gaps encountered during maneuver, destroyed overpasses, anti-tank ditches, narrow streams, the Army uses a very different solution: the Armored Vehicle Launched Bridge (AVLB).

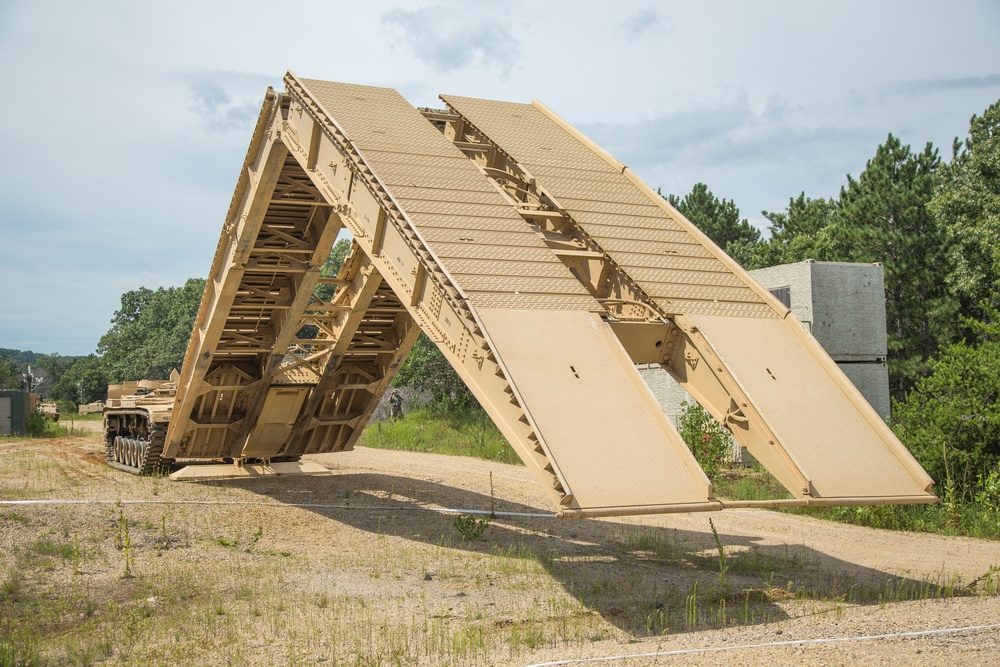

An Armored Vehicle Launched Bridge deploying its folding bridge span from the chassis of a modified tank hull, with the bridge extending forward over a gap
An Armored Vehicle Launched Bridge deploys its span across a gap. The AVLB can place a bridge capable of supporting an M1 Abrams tank in under two minutes, without the crew ever leaving the vehicle.

The AVLB mounts a folding bridge on the chassis of a tank hull, traditionally the M60 or, more recently, the M1 Abrams chassis (the Wolverine Heavy Assault Bridge). The vehicle drives up to the edge of a gap, hydraulically unfolds and lays the bridge across the obstacle, and then backs away. The entire process takes less than two minutes, and the crew never leaves the armored protection of the vehicle.

The tradeoff is span length. An AVLB can bridge gaps of approximately 18 to 24 meters, far shorter than what an IRB can span, but long enough to handle most man-made obstacles and smaller natural waterways. The bridge is rated for MLC 70 or higher, meaning an Abrams can cross immediately. Once the maneuver force has passed, the AVLB can be retrieved and redeployed elsewhere.

The AVLB's value is speed at the point of contact. When a tank company encounters a destroyed bridge during an advance and needs to maintain momentum, calling up a ribbon bridge company and waiting hours for construction isn't an option. The AVLB travels with the maneuver force and delivers a crossing capability in the time it takes to make a cup of coffee.

Why Wet Gap Crossings Remain One of the Hardest Operations in Warfare

Building a bridge is the easy part. Doing it while someone is trying to kill you transforms an engineering challenge into one of the most complex combined-arms operations in military doctrine.

A wet gap crossing requires the integration of virtually every combat function simultaneously. Engineers build the bridge. Infantry secures the near bank and establishes a bridgehead on the far bank. Artillery suppresses enemy positions that could observe or fire on the crossing site. Air defense protects against enemy air attack, a bridge full of vehicles is one of the most lucrative targets on a battlefield. Chemical units screen the crossing site with smoke to obscure it from observation. Military police manage traffic flow to prevent congestion that would create a concentrated target. And all of this must happen under the command and control of a headquarters that synchronizes dozens of moving pieces across a timeline measured in hours.

U.S. Army combat engineers in tactical gear working on bridge components during a field exercise, with military vehicles visible in the background
Combat engineers prepare bridging equipment during a field exercise. Wet gap crossing operations require the integration of infantry, artillery, air defense, chemical, military police, and engineer units, making them one of the most complex operations in modern warfare.

The historical record bears out the difficulty. The Rhine crossings of 1945, at Remagen, Oppenheim, and elsewhere, were among the most heavily planned and supported operations of World War II. The Soviet crossing of the Dnieper in 1943 cost tens of thousands of casualties. Even in exercises, wet gap crossings routinely produce the highest failure rates of any tactical operation.

Modern armies have added new complications. Precision-guided munitions mean that a bridge identified by enemy reconnaissance can be destroyed by a single missile strike. Drones provide persistent surveillance that makes it nearly impossible to hide a crossing operation. Electronic warfare can disrupt the communications needed to coordinate the dozens of units involved. And the proliferation of man-portable anti-tank missiles means that even the far-bank security force faces lethal threats from dispersed enemy infantry.

The Engineers Who Make It Possible

Combat engineers occupy a unique position in the military hierarchy. They are not combat arms in the traditional sense, they don't close with and destroy the enemy as their primary function. But every major combat operation depends on their capabilities. Without engineers, armored divisions stop at rivers. Minefields become impassable. Destroyed infrastructure stays destroyed. The combat power of billion-dollar weapons platforms becomes irrelevant because those platforms can't get to where they need to fight.

The soldiers of the 299th Multi-Role Bridge Company at Objective Peach were Army Reservists, part-time soldiers who had trained for exactly this kind of mission but had never executed it in combat. They built a floating bridge across one of the most historically significant rivers in the world, under wartime conditions, in darkness, and maintained it for two weeks while an armored division rolled across it into Baghdad. Their bridge wasn't glamorous. It didn't make the evening news. But without it, the fastest armored advance in military history would have stopped at the water's edge.

That's the fundamental truth about military engineering. The most decisive capability on any battlefield isn't the tank or the fighter or the missile. It's the ability to keep moving when the terrain says you should stop. And every river crossing, every cleared minefield, every repaired road is a testament to the engineers who make maneuver warfare possible, one aluminum bay at a time.
